Groundbreaking Work Moves Forward at Montgomery Locks and Dam

Pittsburgh District
Published June 18, 2025
Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.

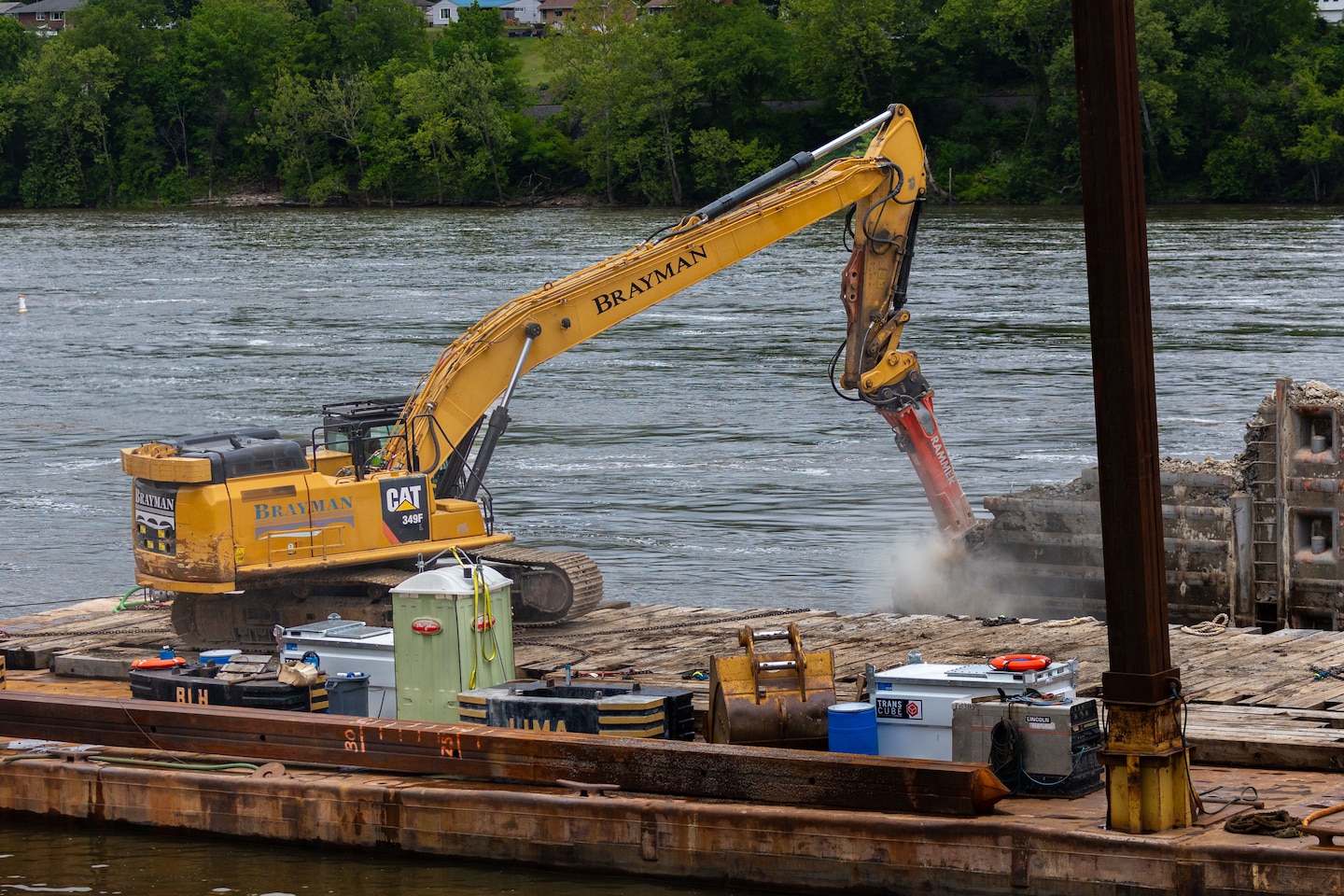

A U.S. Army Corps of Engineers Pittsburgh District contractor uses a hoe ram to demolish a monolith of the lower guard wall at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. Demolishing the lower guard wall is one of the first steps necessary to deconstructing the lock structure – the wall must be brought down to roughly two feet above river elevation, then contractors will remove debris from the river before transporting the debris for disposal. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.

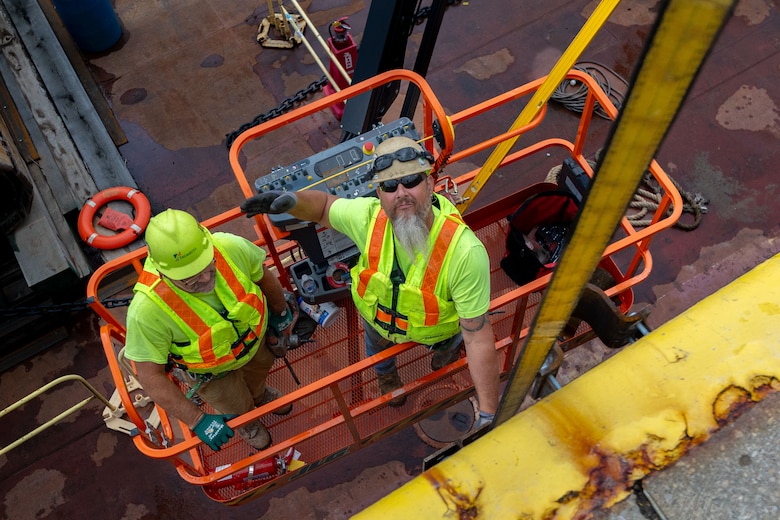

A U.S. Army Corps of Engineers Pittsburgh District contractor, attached to a safety harness, positions a frame piece on top of the quality assurance/quality control lab (QAQC) at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. The QAQC is part of the on-site concrete-batch plant and used to ensure fresh concrete meets structural standards before use in construction. Building the batch plant will allow contractors to produce 400,000 cubic yards of concrete on-site for a new navigation chamber at Montgomery Locks and Dam. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.

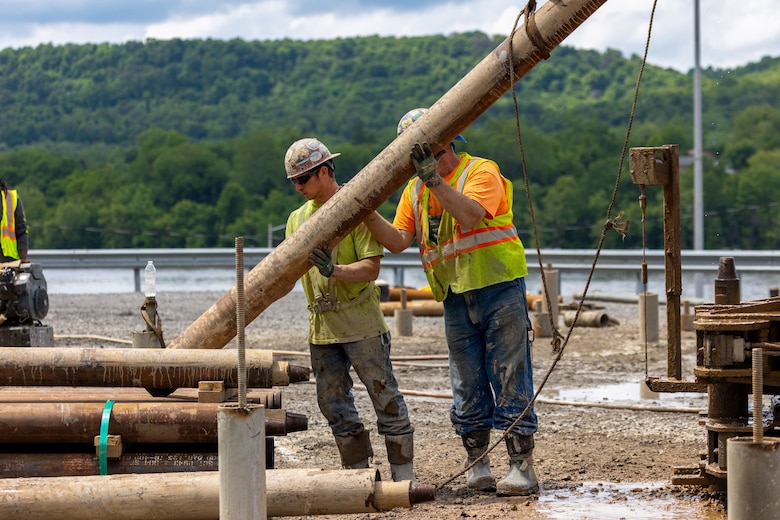

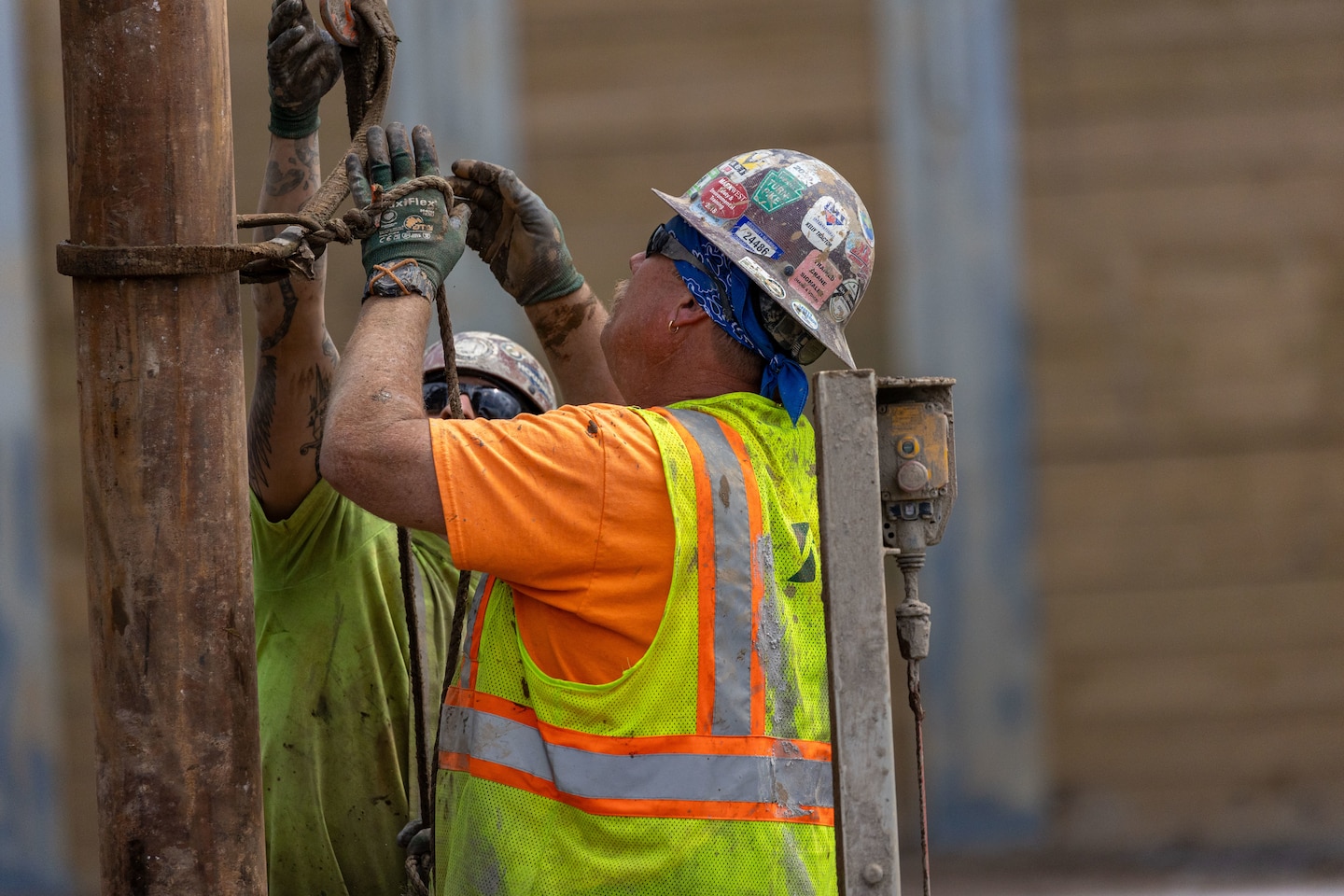

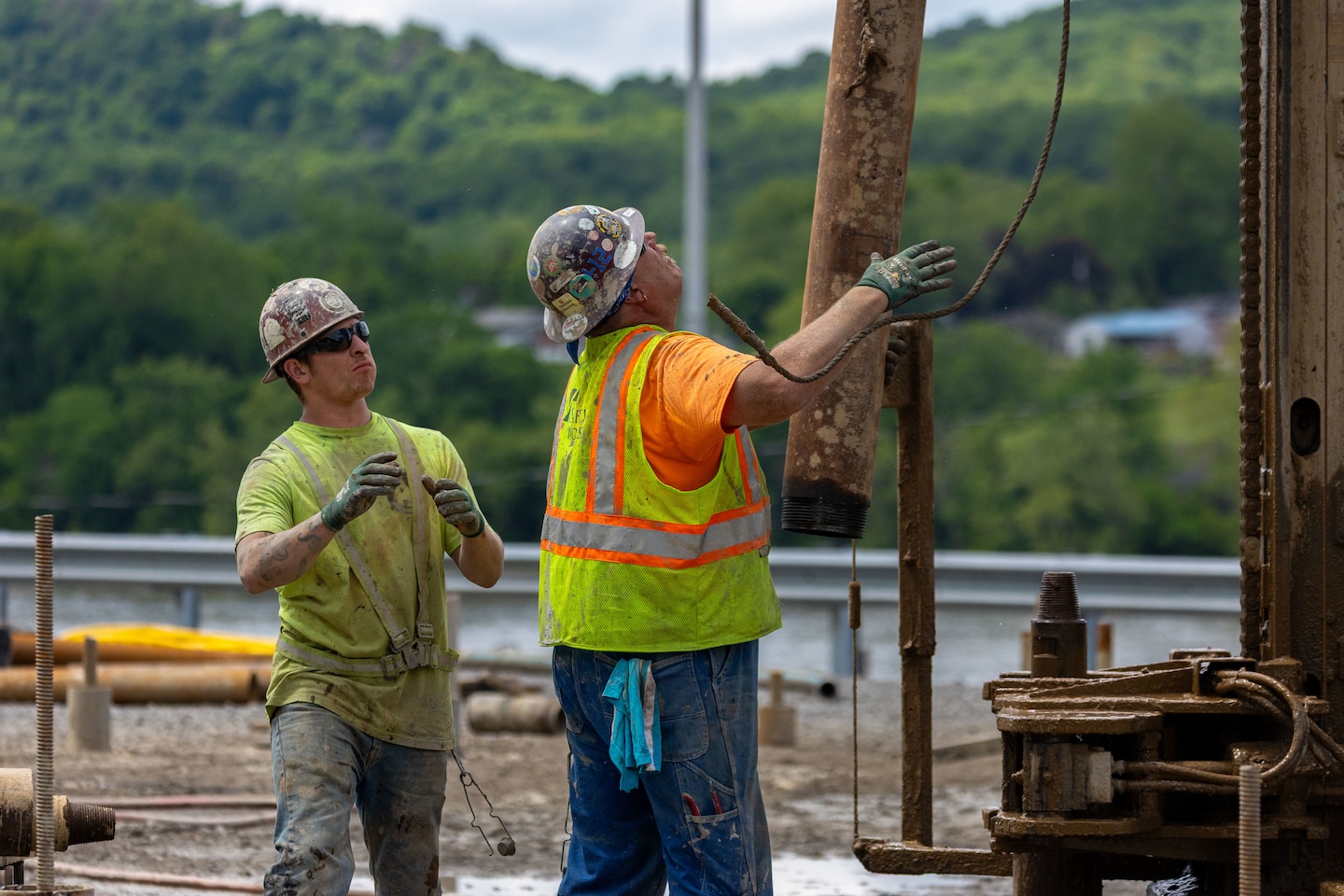

Two U.S. Army Corps of Engineers Pittsburgh District contractors lift metal casing for micropiles at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. Micropiles are a type of deep foundation used to support heavy machinery. The micropiles will support heavy batching equipment used at the on-site concrete batch plant throughout construction, allowing contractors to produce 400,000 cubic yards of concrete on-site for a new navigation chamber at Montgomery Locks and Dam. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.

Two U.S. Army Corps of Engineers Pittsburgh District contractors lift metal casing for micropiles at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. Micropiles are a type of deep foundation used to support heavy machinery. The micropiles will support heavy batching equipment used at the on-site concrete batch plant throughout construction, allowing contractors to produce 400,000 cubic yards of concrete on-site for a new navigation chamber at Montgomery Locks and Dam. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.

Two U.S. Army Corps of Engineers Pittsburgh District contractors lift metal casing for micropiles at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. Micropiles are a type of deep foundation used to support heavy machinery. The micropiles will support heavy batching equipment used at the on-site concrete batch plant throughout construction, allowing contractors to produce 400,000 cubic yards of concrete on-site for a new navigation chamber at Montgomery Locks and Dam. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.

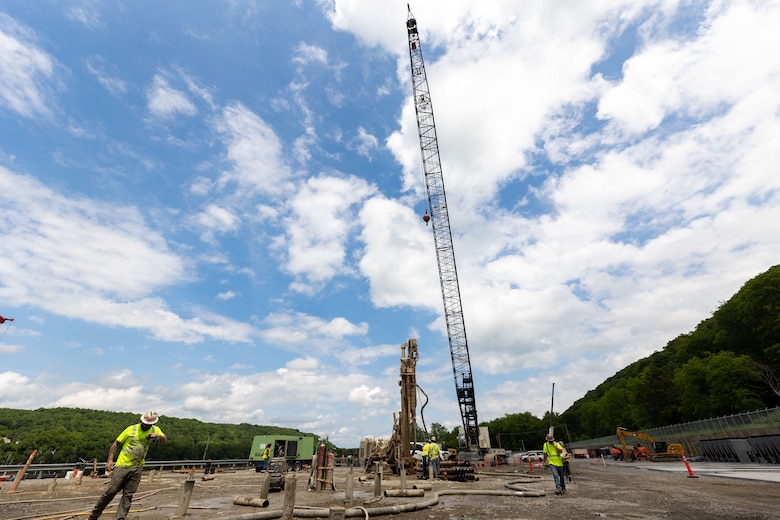

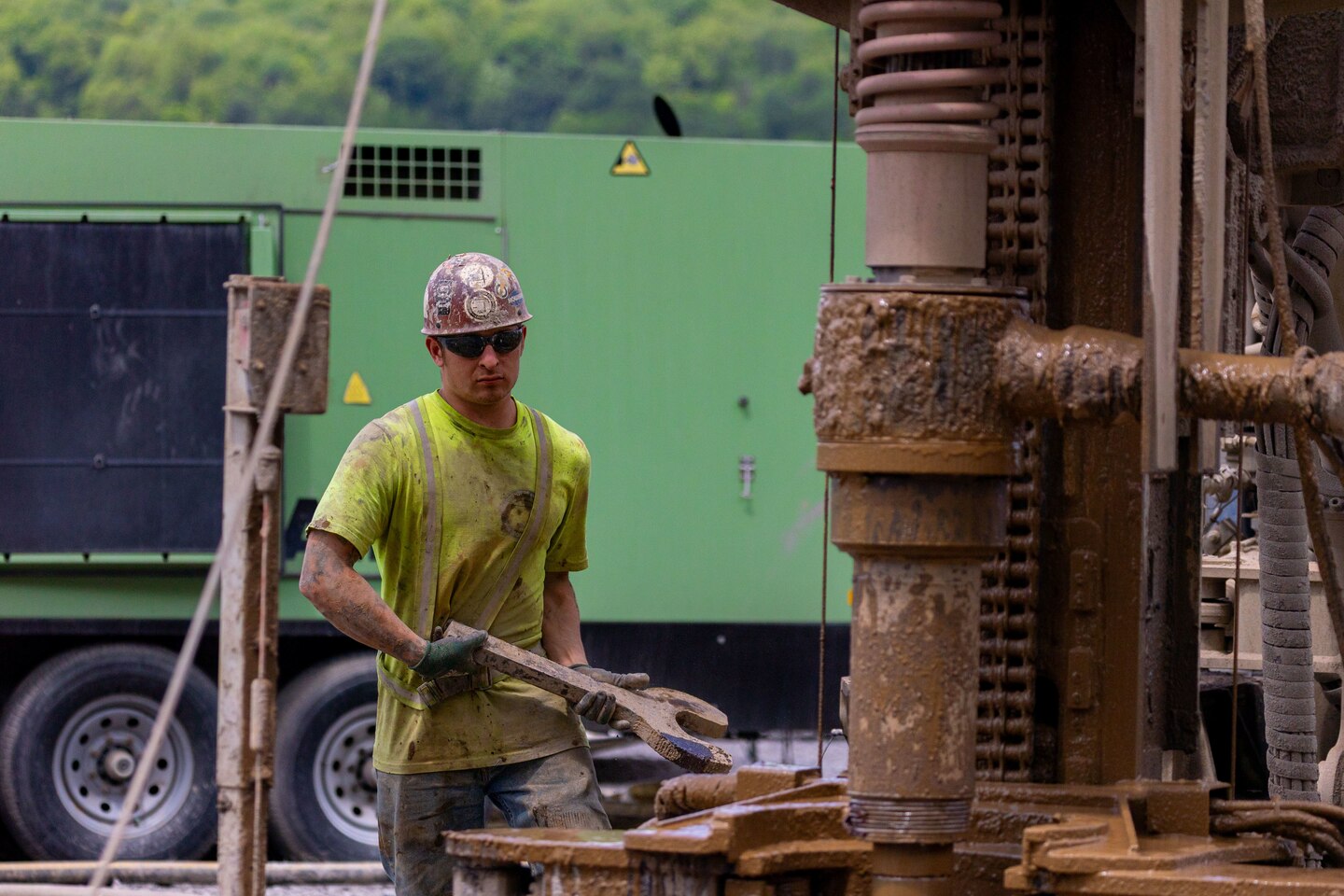

A U.S. Army Corps of Engineers Pittsburgh District contractor approaches a machine used to lift metal casing for micropiles at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. Micropiles are a type of deep foundation used to support heavy machinery. The micropiles will support heavy batching equipment used at the on-site concrete batch plant throughout construction, allowing contractors to produce 400,000 cubic yards of concrete on-site for a new navigation chamber at Montgomery Locks and Dam. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.

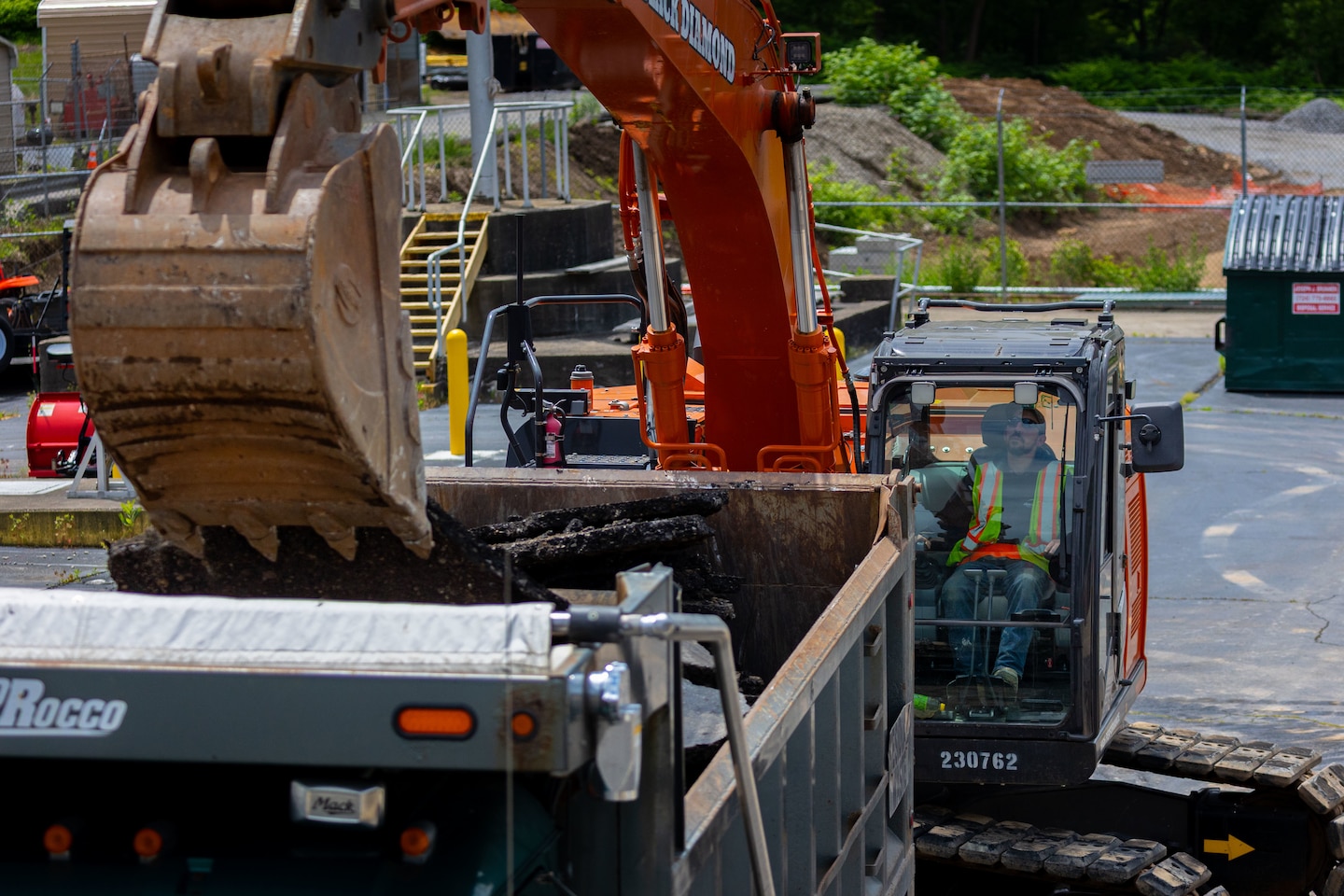

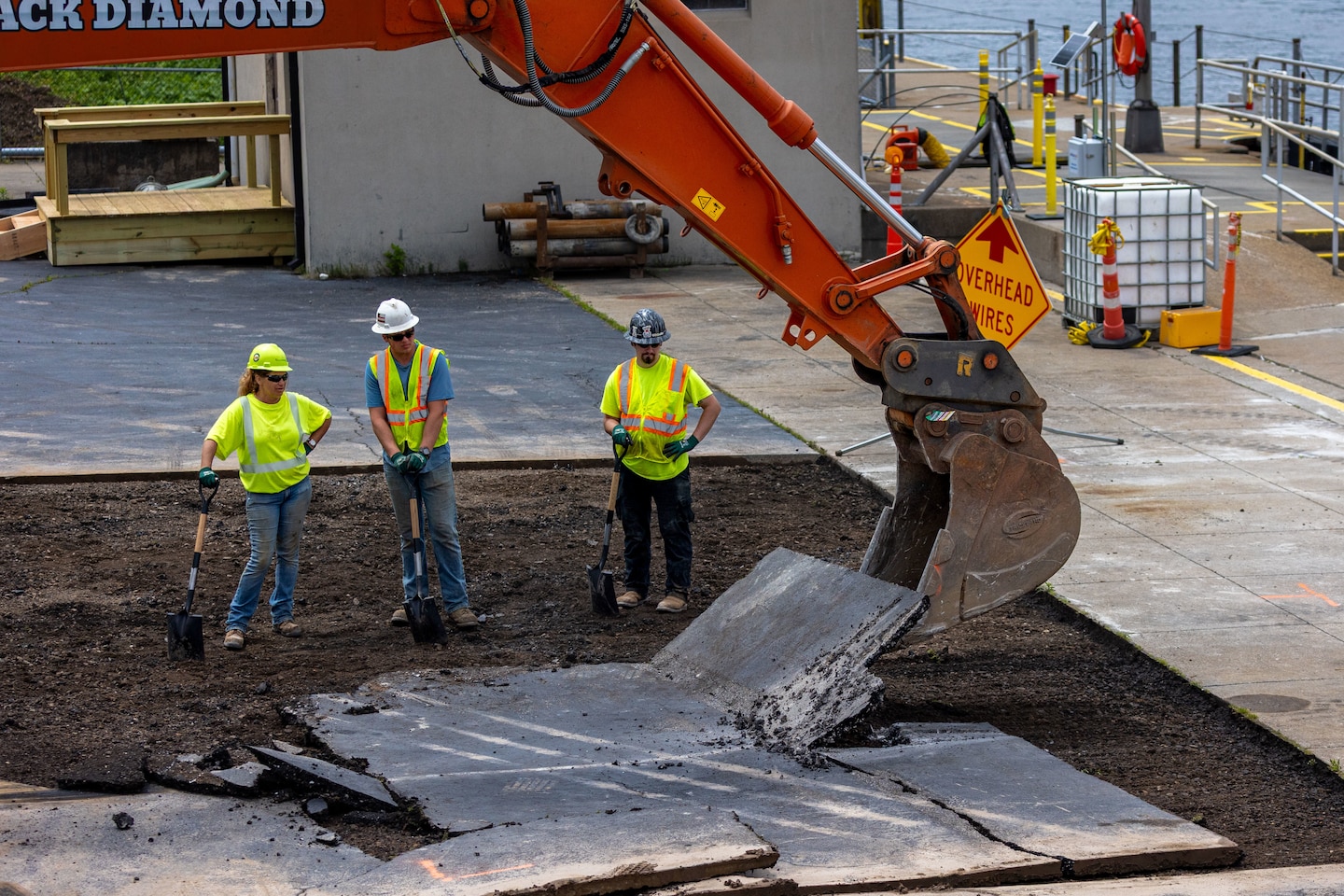

Three U.S. Army Corps of Engineers Pittsburgh District contractors watch a crane remove asphalt from the parking lot at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. The pictured section of the parking lot will be used as a foundation for a temporary utility bridge as well as for concrete conveyors to transport concrete from the on-site batch plant to the lock chamber throughout construction. Building the batch plant will allow contractors to produce 400,000 cubic yards of concrete on-site for a new navigation chamber at Montgomery Locks and Dam. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.

A U.S. Army Corps of Engineers Pittsburgh District contractor uses a crane to remove asphalt from a section of the parking lot at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. The section of the parking lot will be used as a foundation for a temporary utility bridge as well as for concrete conveyors to transport concrete from the on-site batch plant to the lock chamber throughout construction. Building the batch plant will allow contractors to produce 400,000 cubic yards of concrete on-site for a new navigation chamber at Montgomery Locks and Dam. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.

A U.S. Army Corps of Engineers Pittsburgh District contractor uses a crane to remove asphalt from a section of the parking lot at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. The section of the parking lot will be used as a foundation for a temporary utility bridge as well as for concrete conveyors to transport concrete from the on-site batch plant to the lock chamber throughout construction. Building the batch plant will allow contractors to produce 400,000 cubic yards of concrete on-site for a new navigation chamber at Montgomery Locks and Dam. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.
PHOTO DETAILS  /   DOWNLOAD HI-RES 10 of 19

A U.S. Army Corps of Engineers Pittsburgh District contractor uses a hoe ram to demolish a monolith of the lower guard wall at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. Demolishing the lower guard wall is one of the first steps necessary to deconstructing the lock structure – the wall must be brought down to roughly two feet above river elevation, then contractors will remove debris from the river before transporting the debris for disposal. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.
PHOTO DETAILS  /   DOWNLOAD HI-RES 11 of 19

U.S. Army Corps of Engineers Pittsburgh District contractors assemble the frame for the quality assurance/quality control lab (QAQC) at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. The QAQC is part of the on-site concrete-batch plant and used to ensure fresh concrete meets structural standards before use in construction. Building the batch plant will allow contractors to produce 400,000 cubic yards of concrete on-site for a new navigation chamber at Montgomery Locks and Dam. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.
PHOTO DETAILS  /   DOWNLOAD HI-RES 12 of 19

Two U.S. Army Corps of Engineers Pittsburgh District contractors continue installing metal casing for micropiles at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. Micropiles are a type of deep foundation used to support heavy machinery. The micropiles will support heavy batching equipment used at the on-site concrete batch plant throughout construction, allowing contractors to produce 400,000 cubic yards of concrete on-site for a new navigation chamber at Montgomery Locks and Dam. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction workers make groundbreaking progress at a construction site at a navigational lock along a river.
PHOTO DETAILS  /   DOWNLOAD HI-RES 13 of 19

Two U.S. Army Corps of Engineers Pittsburgh District contractors continue installing metal casing for micropiles at Montgomery Locks and Dam in Monaca, Pennsylvania, May 29, 2025. Micropiles are a type of deep foundation used to support heavy machinery. The micropiles will support heavy batching equipment used at the on-site concrete batch plant throughout construction, allowing contractors to produce 400,000 cubic yards of concrete on-site for a new navigation chamber at Montgomery Locks and Dam. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction crews work at a navigational lock along a river.
PHOTO DETAILS  /   DOWNLOAD HI-RES 14 of 19

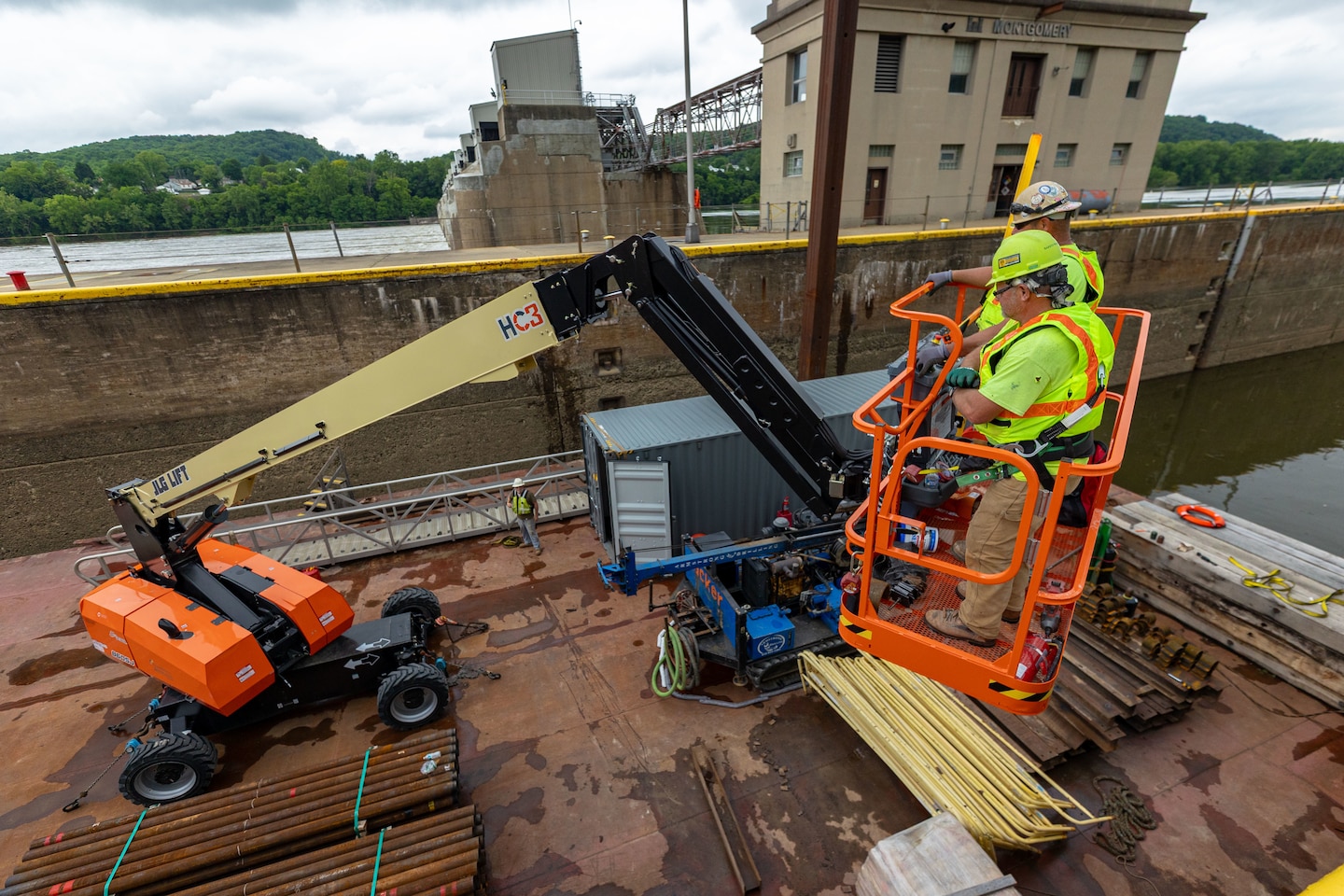

Using a man lift, contractors are lifted into position to secure bumper casing on the middle lock wall at Montgomery Locks and Dam on the Ohio River in Monaca, Pennsylvania, May 29, 2025. As part of preparation for Upper Ohio Navigation Project construction at the lock, the bumper casing will act as a buffer to vessels inside the lock chamber while housing and protecting inclinometers placed along the river, middle, and land walls at the facility. Before major construction begins at the lock, more than 50 inclinometers will be installed to measure the angle the walls lean towards. Inclinometers monitor structural integrity to alert staff if the lock walls move. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction crews work at a navigational lock along a river.
PHOTO DETAILS  /   DOWNLOAD HI-RES 15 of 19

A contractor sets crane-assisted bumper casing on the middle lock wall at Montgomery Locks and Dam on the Ohio River in Monaca, Pennsylvania, May 29, 2025. As part of preparation for Upper Ohio Navigation Project construction at the lock, the bumper casing will act as a buffer to vessels inside the lock chamber while housing and protecting inclinometers placed along the river, middle, and land walls at the facility. Before major construction begins at the lock, more than 50 inclinometers will be installed to measure the angle the walls lean towards. Inclinometers monitor structural integrity to alert staff if the lock walls move. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction crews work at a navigational lock along a river.
PHOTO DETAILS  /   DOWNLOAD HI-RES 16 of 19

A contractor attaches bumper casing to a crane at Montgomery Locks and Dam on the Ohio River in Monaca, Pennsylvania, May 29, 2025. As part of preparation for Upper Ohio Navigation Project construction at the lock, the bumper casing will act as a buffer to vessels inside the lock chamber while housing and protecting inclinometers placed along the river, middle, and land walls at the facility. Before major construction begins at the lock, more than 50 inclinometers will be installed to measure the angle the walls lean towards. Inclinometers monitor structural integrity to alert staff if the lock walls move. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction crews work at a navigational lock along a river.
PHOTO DETAILS  /   DOWNLOAD HI-RES 17 of 19

A contractor secures bumper casing on the middle lock wall at Montgomery Locks and Dam on the Ohio River in Monaca, Pennsylvania, May 29, 2025. As part of preparation for Upper Ohio Navigation Project construction at the lock, the bumper casing will act as a buffer to vessels inside the lock chamber while housing and protecting inclinometers placed along the river, middle, and land walls at the facility. Before major construction begins at the lock, more than 50 inclinometers will be installed to measure the angle the walls lean towards. Inclinometers monitor structural integrity to alert staff if the lock walls move. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction crews work at a navigational lock along a river.
PHOTO DETAILS  /   DOWNLOAD HI-RES 18 of 19

A contractor secures bumper casing on the middle lock wall at Montgomery Locks and Dam on the Ohio River in Monaca, Pennsylvania, May 29, 2025. As part of preparation for Upper Ohio Navigation Project construction at the lock, the bumper casing will act as a buffer to vessels inside the lock chamber while housing and protecting inclinometers placed along the river, middle, and land walls at the facility. Before major construction begins at the lock, more than 50 inclinometers will be installed to measure the angle the walls lean towards. Inclinometers monitor structural integrity to alert staff if the lock walls move. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Construction crews work at a navigational lock along a river.
PHOTO DETAILS  /   DOWNLOAD HI-RES 19 of 19

A contractor secures bumper casing on the middle lock wall at Montgomery Locks and Dam on the Ohio River in Monaca, Pennsylvania, May 29, 2025. As part of preparation for Upper Ohio Navigation Project construction at the lock, the bumper casing will act as a buffer to vessels inside the lock chamber while housing and protecting inclinometers placed along the river, middle, and land walls at the facility. Before major construction begins at the lock, more than 50 inclinometers will be installed to measure the angle the walls lean towards. Inclinometers monitor structural integrity to alert staff if the lock walls move. The Upper Ohio Navigation Project is part of the National Economic Development (NED) plan for improving the upper Ohio River navigation system, specifically the Emsworth, Dashields and Montgomery locks and dams. Emsworth, Dashields and Montgomery, each constructed prior to 1936, are the first three locks and dams on the Ohio River downstream of the Point of Pittsburgh. The three facilities have the oldest and smallest lock chambers operating along the entire river. The project involves replacing the auxiliary chamber at Montgomery Locks and Dam, measuring 56 feet wide by 360 feet long, with locks measuring 110 feet wide by 600 feet long. The Pittsburgh District expects the project to support more than 15,000 jobs nationally throughout the construction period. Transporting commodities on the waterways is four times less expensive than by truck and 33 percent cheaper than by rail. Between 15 million and 20 million tons of cargo travel on the upper Ohio River each year, including mainly coal, but also coke, petroleum products, raw and finished steel, and aggregates. (U.S. Army Corps of Engineers photo by Andrew Byrne)

Big machines and bigger innovations are hard at work upgrading one of the smallest locks on the Ohio River.

The U.S. Army Corps of Engineers (USACE) Pittsburgh District is going big — literally — at Montgomery Locks and Dam, where one of the region’s most ambitious infrastructure projects is underway: building a new primary lock chamber in place of one roughly half its size.

The new chamber is part of the Upper Ohio Navigation project and aims to conduct major construction at the Emsworth, Dashields, and Montgomery locks and dams — which are nearly a century old and the smallest locks on the entire Ohio River.

The Corps of Engineers constructed the Montgomery facility in 1936 and it continues to play a critical role in regional commerce. Every year, between 12 and 20 million tons of cargo — from fuel to building materials — pass through the facility, supporting the Port of Pittsburgh and the broader inland navigation system.

Although the existing infrastructures have exceeded their 50-year operational life, Montgomery, like others, has undergone significant rehabilitation and modernization by the district throughout the decades. However, continuing to piecemeal maintenance and rehabilitation brings risk and carries steep economic stakes.

A single year-long closure at Montgomery could cost nearly $150 million and force shippers to reroute cargo to more than 100,000 railcars or 400,000 trucks — significantly increasing emissions, congestion and costs.

The upgraded lock chamber is designed not only to support larger commercial tows than the existing river chamber can, but also to reduce delays, increase resiliency, and ensure navigational reliability for decades to come.

“This is a generational investment,” said Jenna Cunningham, the project’s resident engineer. “It’s about modernizing our navigation infrastructure in a way that’s smarter, more reliable and sustainable.”

The initial contract for construction work — nearly $770 million — was awarded in late 2024. Since then, contractors have been mobilizing construction equipment, building key infrastructure such as an on-site concrete batch plant, demolishing the existing lock chamber, and laying the literal groundwork for a 110-foot by 600-foot lock chamber — nearly double the size of the existing chamber. The effort is designed to ensure reliable and efficient navigation along the upper Ohio River.

Since the initial contract award, contractors have installed temporary field offices, erected fencing and power infrastructure, constructed new stormwater drainage systems, and have begun demolishing the lower guard wall. The contractors have started constructing the foundations for batch plant equipment. Building the batch plant on-site, along with a quality assurance and control lab, enables the contractors to mix at least 150 cubic yards of concrete per hour, produce high-quality concrete, and minimize logistical delays.

Along the middle lock walls, contractors are installing inclinometers — long, vertical instruments that detect subtle shifts in the earth.

“These inclinometers are designed to measure any horizontal movement of the wall during and after construction,” said Andrew Aceves, a geologist with the district. “Each one is installed in a cored shaft that extends several dozen feet along the lock wall, with outer casings secured to ensure long-term integrity.”

More than 50 inclinometers will continuously monitor the lock wall during construction to alert engineers to any movement by providing real-time updates through an automated system. The system is essential for preventing unintended structural shifts and ensuring industry vessels can continue to lock through during construction.

According to Cunningham, the current activities are part of the “startup and mobilization” phase and are roughly 40 percent complete.

“This is one of the main benefits of receiving bulk funding at the outset,” Cunningham said. “Because we’re using a single contractor with a base-plus-options structure, we’re minimizing the need for repeated mobilization, separate contract awards and long procurement timelines.”
